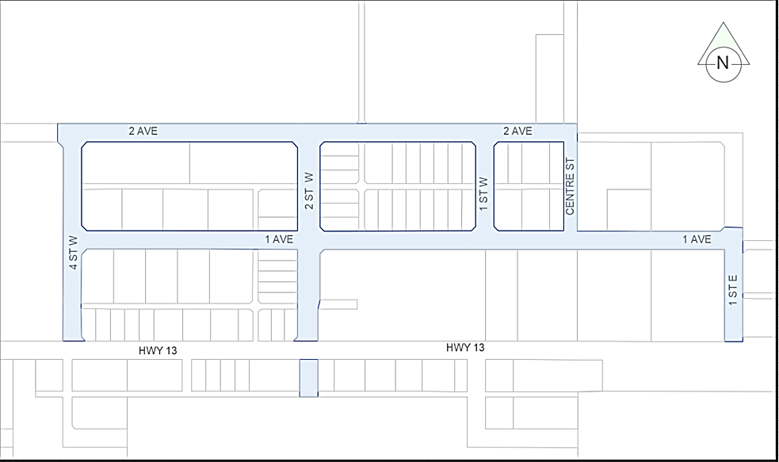

Road Construction Alder Flats
Project Description:
This project focuses on improving road conditions at various locations in Alder Flats. Phase 1, awarded to PME Inc., includes grading and base work in preparation for paving. Phase 2, awarded to TBL Construction Ltd., involves upgrades to additional key streets, and paving of roads completed in phase 1 and 2.
Scope of Work:
- Clearing
- Common Excavation
- Borrow Excavation
- Culvert Removal/Installation
- Concrete Sidewalk Removal
- Concrete Sidewalk installation
- Supply, Haul and Place Granular Base Course
- Adjust Manholes
- Permanent Highway signing
- Asphalt Concrete Pavement
We understand construction can be inconvenient and may cause minor delays, but your patience and cooperation are crucial. Let's work together to maintain a safe construction site throughout the project.

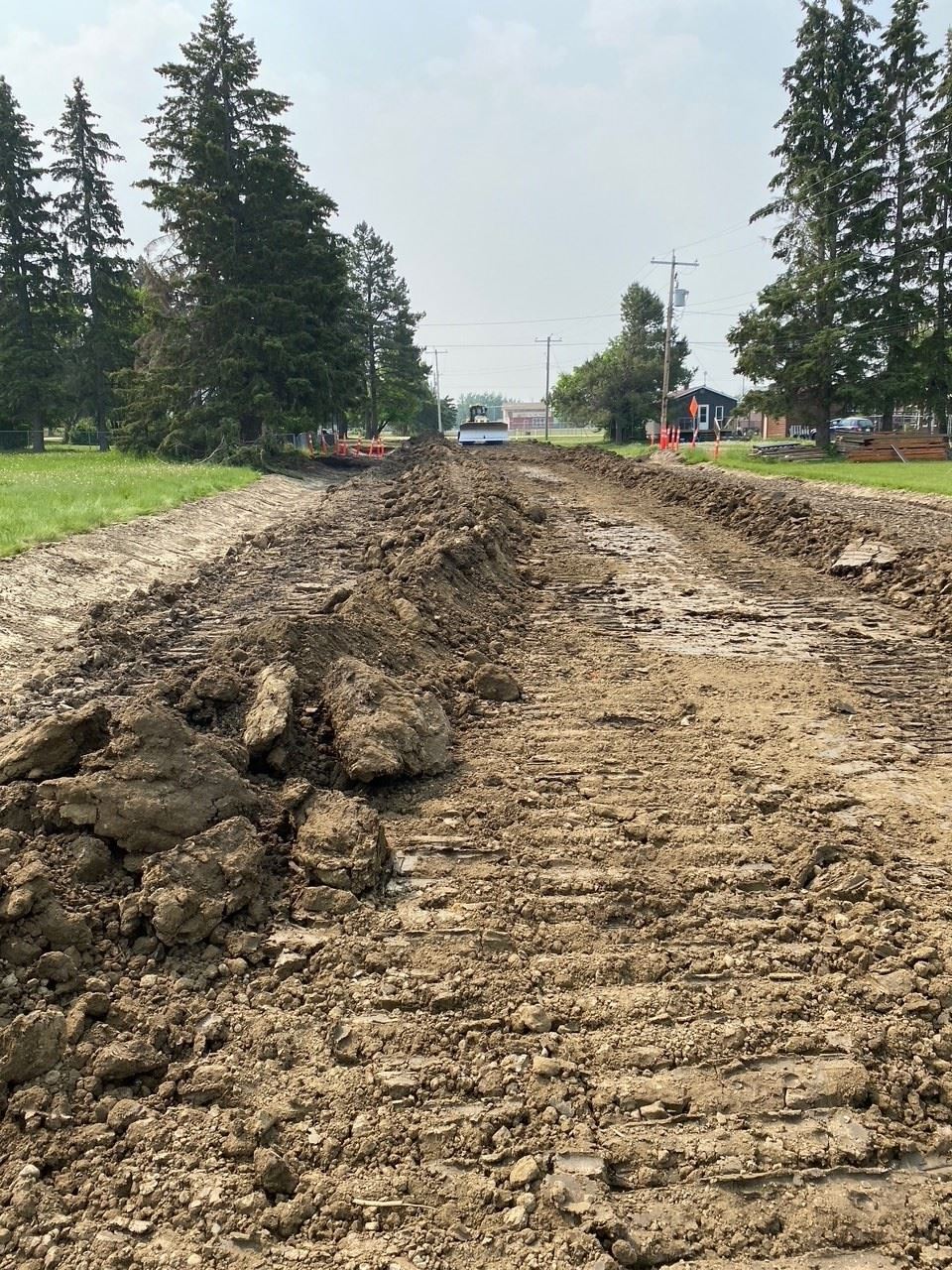

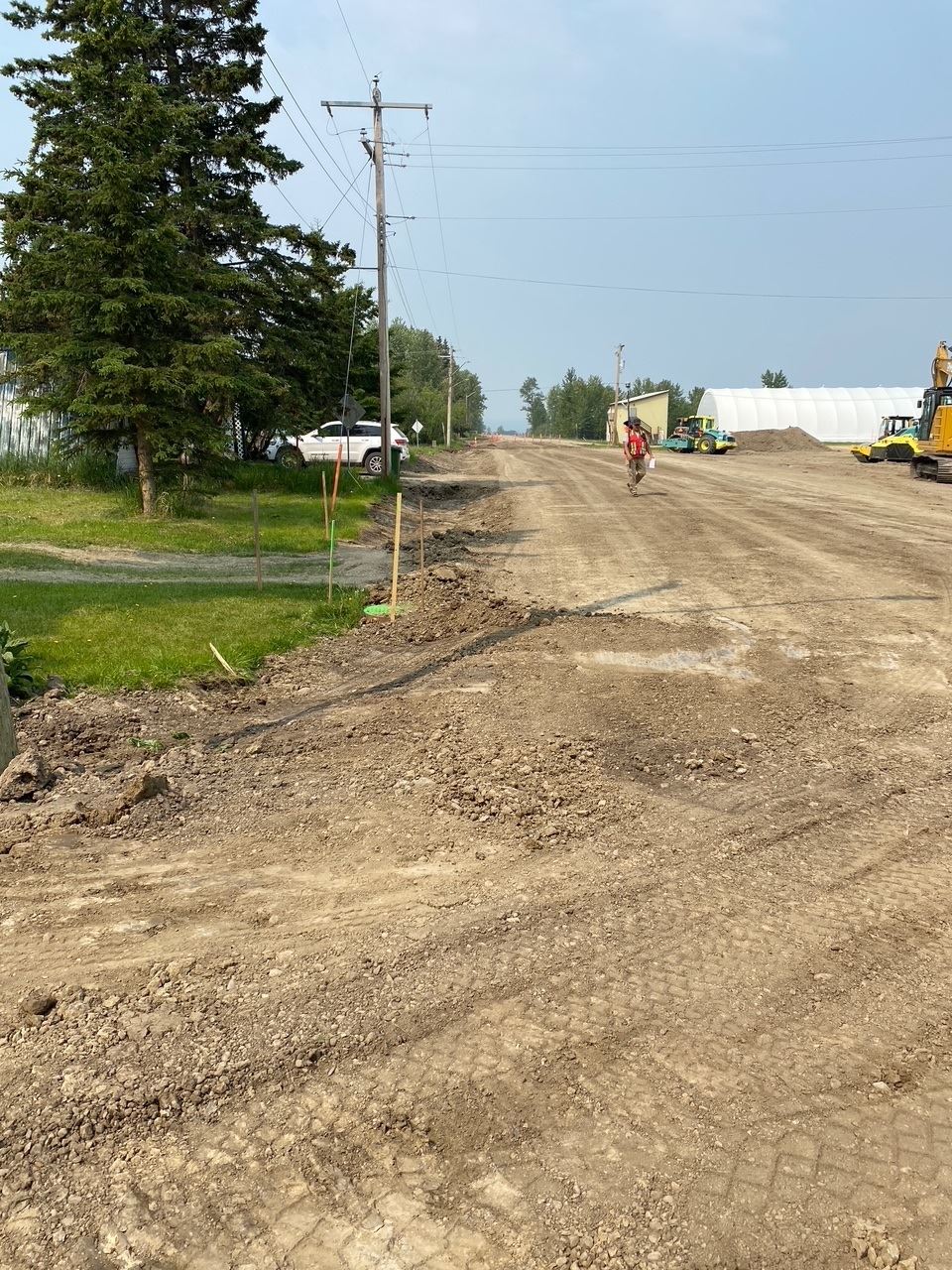

Tree Clearing is complete, lowering of select Natural Gas lines to be completed within next 2 weeks, construction to follow.
- Phase 1: Construction crews will be on-site for approximately 25 to 35 days. This timeline does not include days when work cannot proceed due to inclement weather.
- Phase 2: Construction crews will be on-site for approximately 30 to 35 days. This timeline does not include days when work cannot proceed due to inclement weather or scheduled days off.

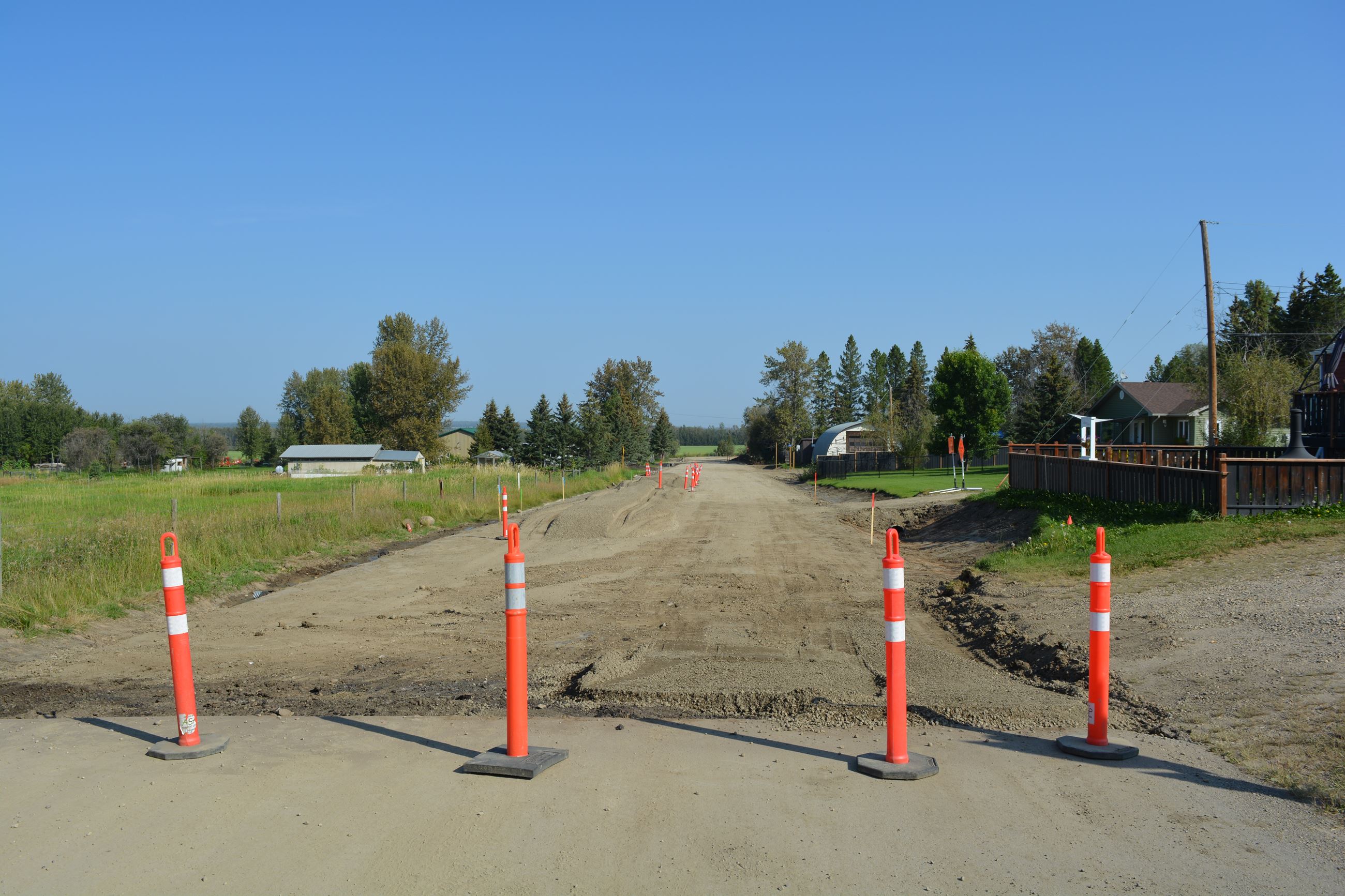

- As this is a grading project, the sidewalk and one or two traffic lanes may be closed at times. Drivers will be required to reduce speed and be prepared to stop.
- When one lane is closed, a flag person will direct traffic. If two lanes are closed, an on-site detour road will be provided.
- Drivers may experience discomfort due to rough road conditions and dust during the construction season.
- Advance notice will be given to nearby residents, and temporary traffic signals will be in place.

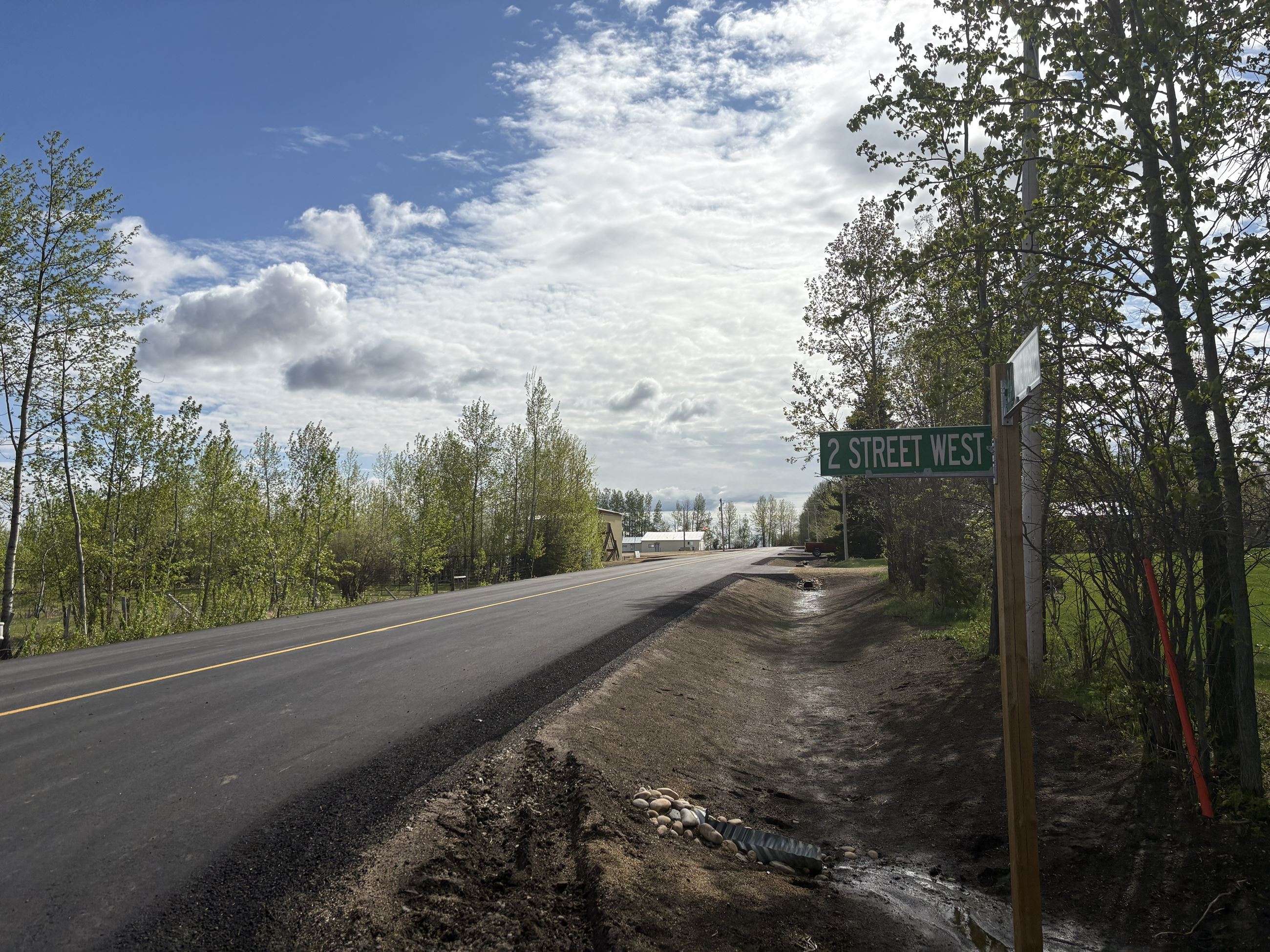

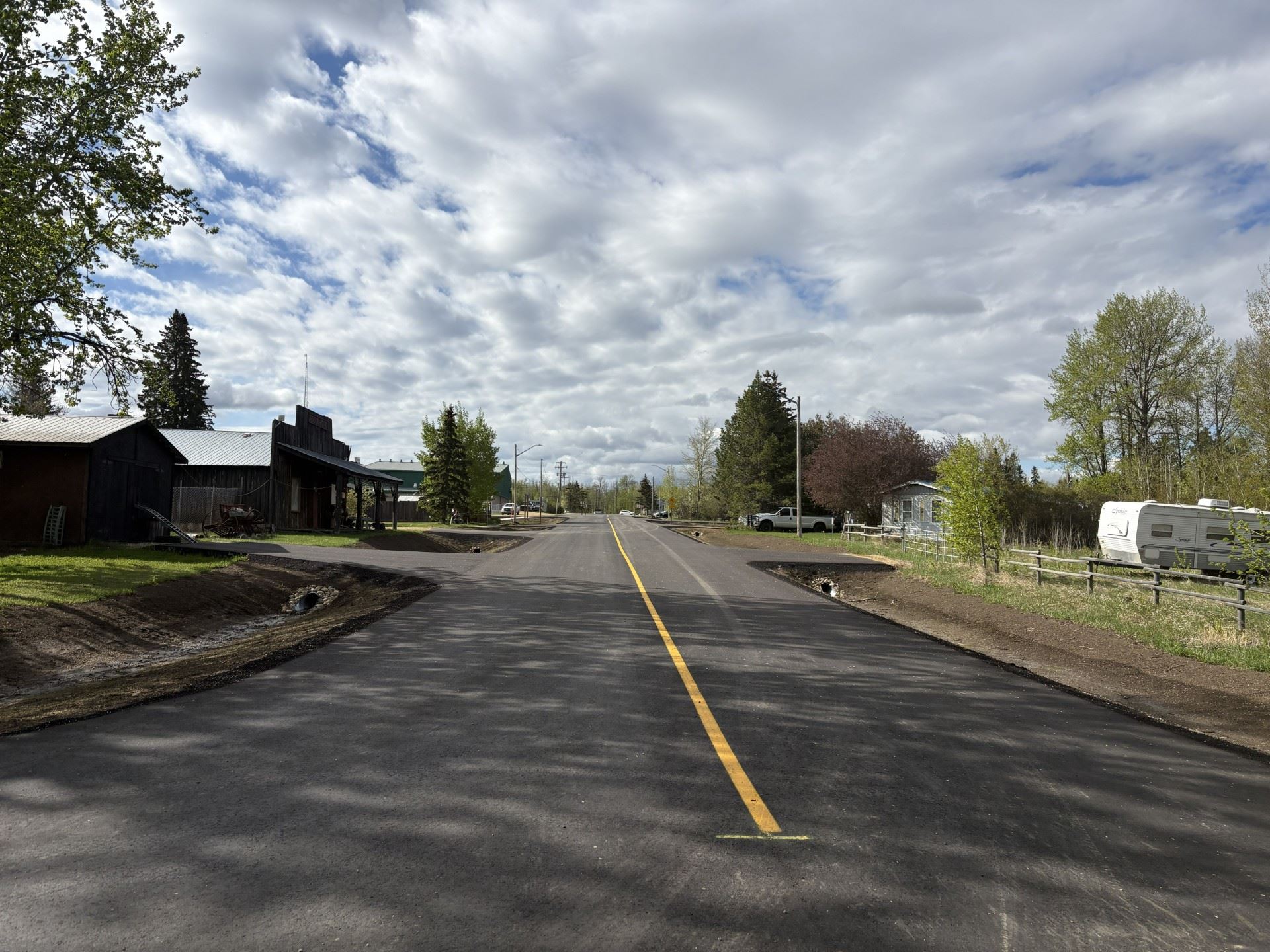

- A second notice of construction will be issued once paving operations to begin.
- Start date: Summer 2024
- Estimated completion date: October 31, 2025
- Project Cost: Phase 1 - $1,280,000 & Phase 2 - $1,692,857.53
- County Contact: Dallas Vikse, Acting Director of Public Works - 780-352-3321
- Engineering Contact: Mark Massing, WSP - 403-598-2710
